GOWGANDA SILVER TAILINGS

District-Scale Silver Tailings. Four Decades of Validated Metallurgy.

The Gowganda silver tailings are supported by four decades of independent drilling, metallurgical testing, and engineering work by firms including Watts Griffis & McOuat and GeoVector Management. Nord's January 2026 acquisition of four historic mining leases consolidated the principal tailings deposits and adjacent infrastructure under a single operator for the first time in the district's 116-year history.

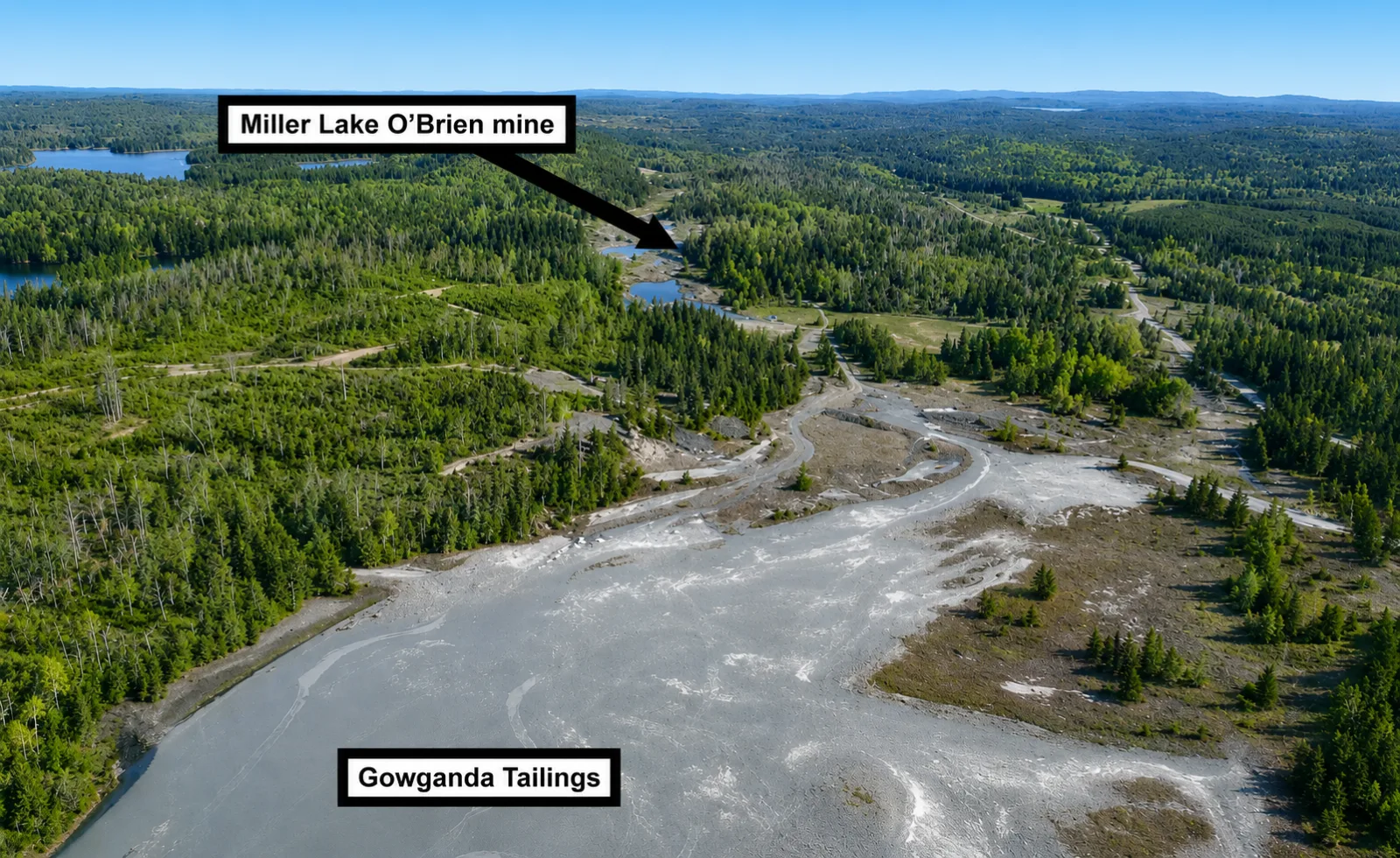

Aerial view of the Gowganda Tailings with Miller Lake O'Brien mine in the background

REGIONAL CONTEXT

The Cobalt-Gowganda Silver District

The broader Cobalt-Gowganda district has produced over half a billion ounces of silver since 1903. The Cobalt Camp proper accounts for approximately 460 million ounces. The Gowganda satellite camp, 50 km to the west, contributed over 60 million ounces, principally from the Miller Lake O'Brien and Siscoe operations between 1910 and 1972.

The Gowganda tailings sit adjacent to Nord's Castle Mine property, approximately 100 km west of TTL Laboratories in the town of Cobalt. The surrounding region hosts Agnico Eagle's Macassa and Upper Beaver projects, Alamos Gold's Young-Davidson mine, and IAMGOLD's Côté Gold, placing Nord's silver assets within one of northeastern Ontario's most actively mined corridors.

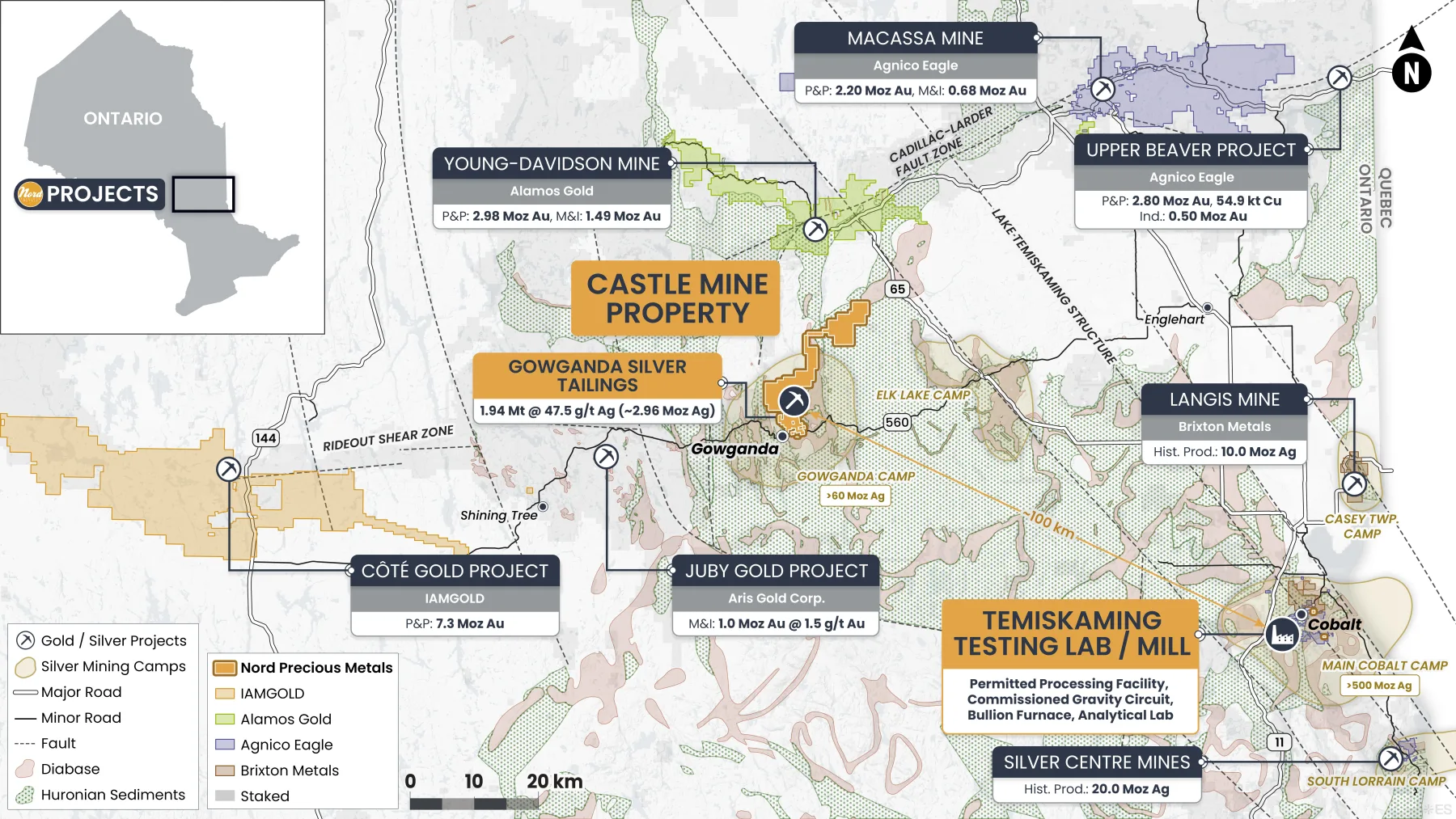

Regional map showing Gowganda Silver Tailings, Castle Mine, and the Temiskaming Testing Lab within the Cobalt-Gowganda camp

TECHNICAL WORK

Four Decades of Drilling, Sampling, and Engineering

The Gowganda tailings have been the subject of sustained independent investigation since 1981. Each successive program was conducted by a different firm.

1981

Watts, Griffis & McOuat

545 auger + 26 drive pipe holes (1,570 m).
~1.7M tons at 1.45 oz/t Ag, 82% recovery.
Cyanide leach, Lakefield Research.

2000

Sandy K Mines sonic drill program

32 holes in the core area.
Average 2.0 oz/t Ag, 40% above deposit mean.
Concluded earlier resource underestimated by 25%+.

2011

Temex Resources / GeoVector

Metsolve thiosulfate testwork; 764 holes (3,012 m) integrated.

2026

Nord / GeoVector MRE update

860+ holes incl. 103 BMR sonic with multi-element sampling.
Consolidated land package.
Updated estimate expected H2 2026.

GEOVECTOR 2011 TECHNICAL REPORT

GeoVector Management 2011 NI 43-101 Technical Report

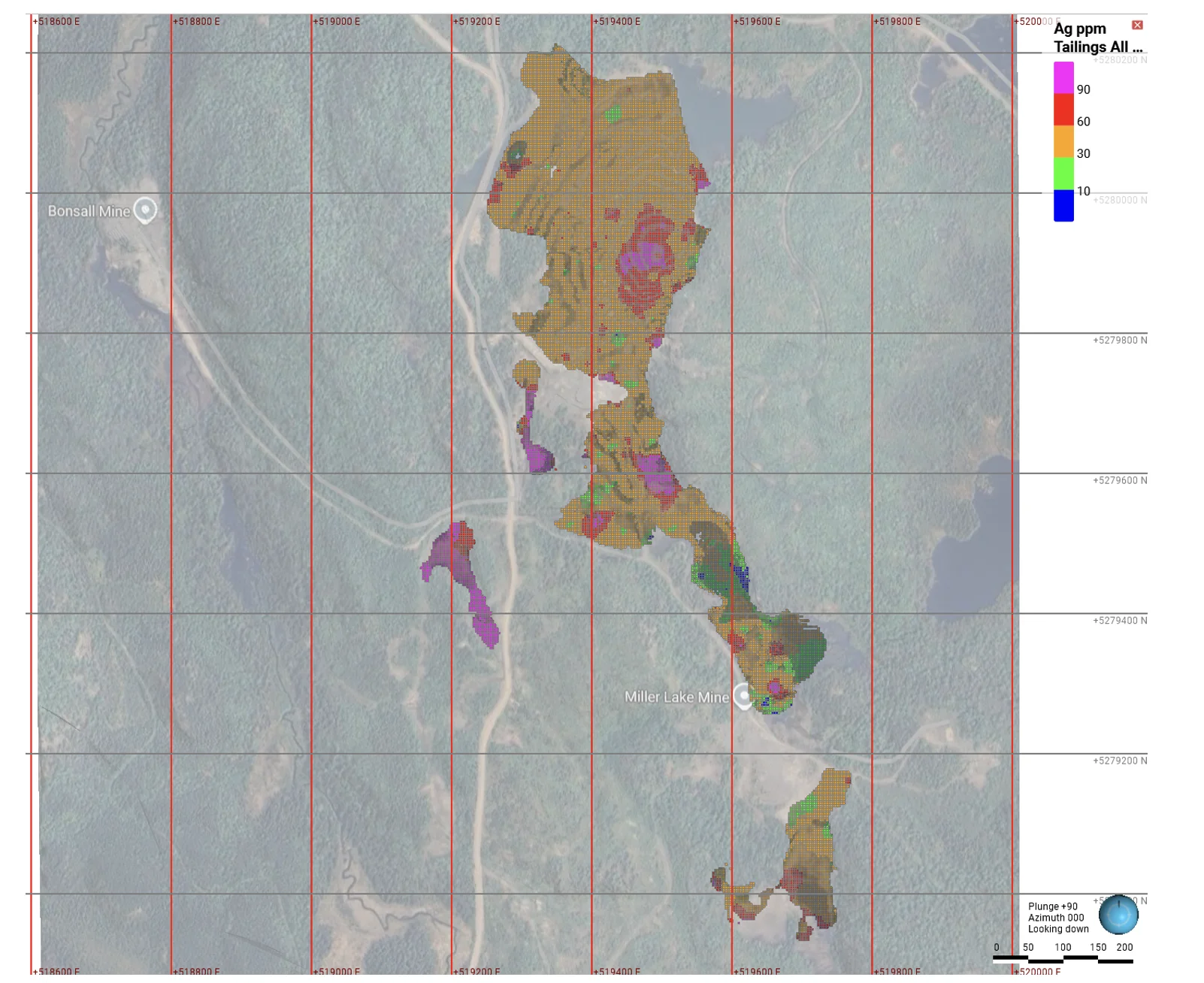

GeoVector Management's 2011 NI 43-101 technical report integrated 764 drill holes across three campaigns (1981, 1986–87, 2000) into a block model using inverse distance squared interpolation.

JULY 2011

GeoVector / Temex Resources — NI 43-101 Technical Report on the Gowganda Silver Property

Source: GeoVector Management Inc., NI 43-101 Technical Report, July 8, 2011. Historical estimate; the Company is not treating it as a current mineral resource under NI 43-101 unless reaffirmed by a qualified person.

ACQUIRED LEASES & GEOLOGY

Past Producers Within a Single Contiguous Land Package

The newly acquired BMR leases consolidate four historic past producers — including Miller Lake-O'Brien, Millerett, and Bonsall — onto a single contiguous land package adjacent to Nord's existing Castle Mine and Castle East discovery. All deposits are hosted in the same Nipissing diabase-hosted, native-silver vein system that defines the broader Cobalt-Gowganda camp.

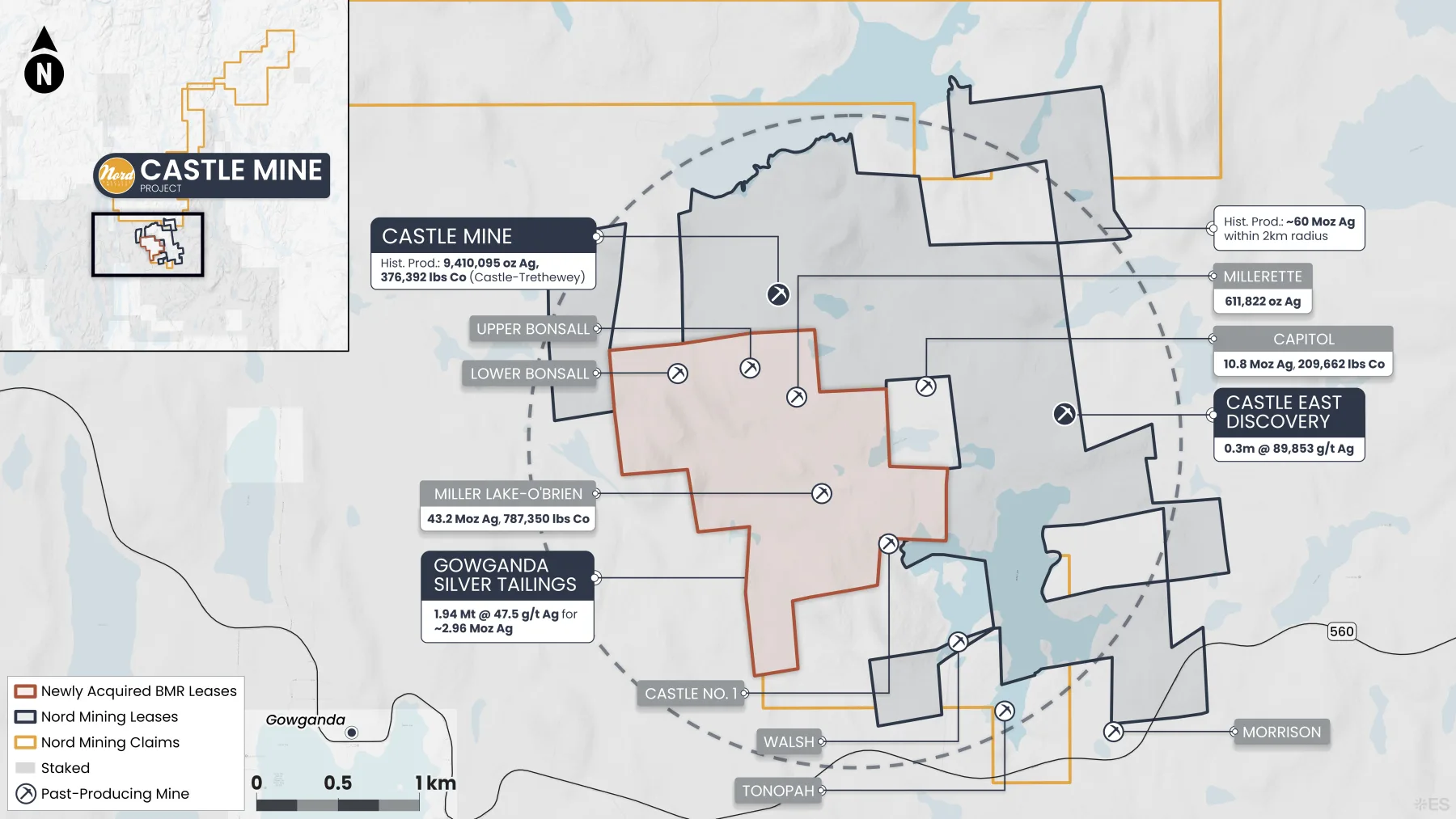

Detailed claim map of the Castle Mine property showing the newly acquired BMR leases, Gowganda Silver Tailings, and adjacent past producers including Miller Lake-O'Brien, Millerette, Capitol, and Bonsall

PAST PRODUCTION

Combined historical output exceeds 53 million ounces of silver

Across four contiguous past producers now under Nord's control — Castle-Trethewey, Miller Lake-O'Brien, Millerette, and Bonsall — historical silver production exceeds 53 million ounces. For the first time in the district's history, this production base sits under a single operator, with proximate access to Nord's Castle Mine workings, the Temiskaming Testing Lab in Cobalt, and the Company's planned 600 TPD modular gravity plant — creating one consolidated platform for the next round of resource definition and recovery work.

Miller Lake-O'Brien (oz Ag)

Castle-Trethewey (oz Ag)

Millerette (oz Ag)

Bonsall (oz Ag)

Historical production figures compiled from Ontario Geological Survey and operator records. Historical production is not indicative of any current mineral resource or reserve.

PROCESSING STRATEGY

Processing Architecture: Leach Plant and District Infrastructure

The Gowganda tailings require a hydrometallurgical processing route. Independent metallurgical test programmes have evaluated both cyanide leaching (WGM / Lakefield, 1981) and thiosulfate leaching (Temex / Metsolve, 2006–07), a non-cyanide alternative. These established processing baselines will inform the Company's evaluation of next steps once the updated GeoVector mineral resource estimate is complete.

The silver precipitate produced by the Merrill-Crowe process may be refined at the Company's TTL Laboratories facility in Cobalt, Ontario, which maintains furnace capacity for the production of silver doré. The solid leach residue from silver recovery is expected to contain recoverable quantities of cobalt, nickel, and other strategic metals in arsenide and sulfarsenide form. The Company has validated hydrometallurgical processing routes for arsenical concentrates through independent testwork programmes and intends to evaluate the residue as a potential secondary recovery stream.

District Processing Infrastructure

Beyond the Gowganda tailings, Nord maintains processing infrastructure that serves the broader Cobalt-Gowganda district. TTL Laboratories is the only permitted high-grade milling facility in the Cobalt Camp, operating gravity circuits, a furnace, and an assay laboratory. The Company's 600 TPD modular gravity plant awaits commissioning under the recovery permit framework.

These facilities are designed for feed sources where the silver mineralogy is amenable to gravity concentration. Testwork on Beaver Mine tailings has produced commercial-grade high-grade silver concentrate via gravity recovery (October 6, 2025 press release), confirming that certain district tailings and waste rock streams can be processed through existing equipment. Historical underground workings across the consolidated property also contain broken ore material in stopes that was never hoisted to surface. This material, if quantified through sampling, would represent an additional gravity-amenable feed source.

The phased approach — gravity processing of amenable district materials through existing infrastructure, concurrent with development of a purpose-built leach facility for the Gowganda tailings — supports advancing the Gowganda tailings project through permitting and technical evaluation, with each processing route serving the feed source for which it is metallurgically suited.

PATH FORWARD

Next Steps

Expected H2 2026

Updated Mineral Resource Estimate

GeoVector Management has been retained with two of three original QP authors and all original modelling data. The update will integrate 860+ drill holes across the consolidated land package.

Permitting

Recovery Permit

Advancing under Ontario's 80-day fast-track framework. Specialist permitting consultants and T-Engineering (environmental compliance and paste backfill engineering) are engaged. The Ontario Ministry of Mines has provided an advanced template and confirmed the regulatory pathway.

Underway

Confirmatory Metallurgical Testwork

Tailings samples have been collected. Testwork is underway to confirm the 2007 Temex / Metsolve metallurgical results under current standards and to evaluate both cyanide and thiosulfate processing routes.

Post-MRE

Advancing the project to its next phase

Following completion of the updated mineral resource estimate, the Company plans to advance the Gowganda Silver Tailings to its next phase of project work.

KEY DOCUMENTS

Technical References

SEDAR+ • JULY 2011

NI 43-101 Technical Report — GeoVector / Temex Resources

Leslie Engineering • FEBRUARY 2000

Silver Recovery Project Pre-Feasibility Study — Order of Magnitude Capital Cost Estimate
